What Does a Realistic Home Building Timeline Look Like This Year?

New construction home exterior curb appeal in Omaha Nebraska suburban neighborhood
Table of Contents

What you need to know now about the home building timeline:

  • The Direct Answer: Expect a 7 to 10-month window from the moment you pick your lot to the day you turn the key, though move-in ready specs can cut that to 60 days.
  • The Paperwork: Actual construction only takes about 5 to 7 months; the rest of your time is consumed by permitting, financing, and the design selection process.
  • The Weather Wildcard: Omaha’s climate is the ultimate variable. Starting your build in April typically saves you two full months compared to a late-October start.
  • Decisiveness Wins: Choice fatigue is the biggest internal delay, so finalizing your design decisions early is the only way to keep your closing date from sliding.

Keep reading to see the phase-by-phase breakdown and learn how to shave weeks off your move-in date.

What Is the Full Home Building Timeline From Start to Finish?

Building a new home moves through nine distinct phases:

  • pre-planning and financing,
  • lot selection,
  • design and permitting,
  • site preparation,
  • foundation,
  • framing,
  • mechanicals,
  • interior finishes,
  • final inspection.

For a semi-custom home in Omaha, the full timeline from initial consultation to move-in runs 7 to 10 months. Most of the variance comes from permitting speed and finish selection timing, not construction itself.

How to Build a New Home Step by Step: Every Phase Explained

Phase 1: Pre-Planning, Financing, and Lot Selection (4 to 8 Weeks)

This is where most buyers underestimate the time commitment.

Getting pre-approved for a construction loan is not the same as getting pre-approved for a standard mortgage. Lenders scrutinize builder financials, draw schedules, and appraisal methods. Plan 2 to 3 weeks for the financing piece alone.

Simultaneously, you are selecting your lot and floor plan. At Regency, this happens in a single coordinated conversation. Lot availability, plan fit, and community selection happen together. That eliminates the back-and-forth that can stretch this phase to 3 months with a fully custom builder.

What happens in this phase:

  • Pre-approval for construction-to-permanent financing
  • Lot selection in your target community (Falling Waters, Silver Meadows, Papillion, Bennington, Council Bluffs, and others)
  • Floor plan selection from Regency’s plan collections
  • Initial scope and budget alignment

Regency Homes is the Best of Omaha 2026 winner. Their virtual design and pricing tool lets you configure your new home, select your lot, and get a real price estimate before you ever pick up the phone. Design and Price Your New Regency Home Virtually →

Phase 2: Design Selections and Permitting (3 to 6 Weeks)

Permit timing in the Omaha metro varies by municipality.

Papillion and Bellevue typically turn permits in 2 to 3 weeks. Bennington and Council Bluffs run slightly longer. Regency’s team files permits and tracks status. That is not your task to manage.

The bigger timeline risk here is design selections. Cabinet lead times, flooring availability, and window order windows are real constraints. Buyers who complete selections quickly keep this phase at 3 weeks. Multiple rounds of revisions can push it to 6 weeks or longer.

What to decide before permits are filed:

  • Exterior elevation and materials
  • Window and door packages
  • Structural options (bedroom count, garage configuration, finished basement)

What can wait until after permit approval:

  • Interior paint colors
  • Hardware and fixtures
  • Countertop slab selection

Phase 3: Site Preparation and Foundation (2 to 4 Weeks)

Site prep is deceptively fast when conditions cooperate.

In Omaha’s climate, the primary variable is ground condition in early spring. Frozen or saturated soil delays excavation. Summer and fall starts are consistently faster; most Regency site preps run 1 to 2 weeks. Winter starts add a week or more depending on ground temperatures.

Steps in this phase:

  1. Lot clearing and grading
  2. Excavation for basement or crawl space
  3. Underground plumbing rough-in
  4. Footings poured and inspected
  5. Foundation walls formed, poured, and cured (7 to 10 days for concrete cure)
  6. Waterproofing and drainage tile installed
  7. Backfill complete

Nebraska soil conditions vary by community. Regency’s team has built across every submarket in the metro and knows the site-specific variables before ground breaks.

Phase 4: Framing (4 to 6 Weeks)

Wood framing in progress on new construction home in Omaha Nebraska

Framing is the phase buyers find most exciting, and the most weather-dependent.

In a good Nebraska summer, a standard Regency floor plan frames out in 3 to 4 weeks. Winter framing adds time, but it does happen. Exterior sheathing, windows, and doors get installed at the tail end of this phase, bringing the home to “dried-in” status and protecting interior work from the elements.

Framing milestones to watch:

  • Floor system and subfloor complete
  • Exterior walls stood and braced
  • Roof trusses set and sheathed
  • Windows and exterior doors installed
  • Home is weather-tight

This is also when your home starts to feel real. Plan to visit the site during framing. Walk the layout. Measure rooms with a tape measure. Questions about window placement and room flow are much easier to address now than after drywall.

Phase 5: Mechanicals: Plumbing, Electrical, and HVAC (3 to 5 Weeks)

This phase is invisible to the eye but represents the bulk of the home’s infrastructure.

Rough-in plumbing, electrical panel and wiring, and HVAC ductwork all go in before insulation. Each trade has its own inspection. In Douglas and Sarpy Counties, mechanical inspections generally run 3 to 5 business days. Scheduling all three trades to sequence properly is the coordination challenge. Regency’s project managers handle this.

Rough-in inspection sequence:

  1. Framing inspection (required before mechanicals begin)
  2. Rough plumbing inspection
  3. Rough electrical inspection
  4. Rough HVAC inspection
  5. Insulation inspection (required before drywall)

Nebraska Energy Code requires insulation to meet or exceed IECC 2021 standards. Regency builds to these requirements as standard, not as an upgrade.

Phase 6: Insulation and Drywall (2 to 3 Weeks)

Insulation goes up fast. Typically 1 to 2 days for a standard plan.

Drywall is where the pace slows slightly. Hanging, taping, mudding, and finishing takes 10 to 14 days for most Regency floor plans.

Drywall mud requires drying time between coats and you cannot rush it. Trying to accelerate this phase is one of the most common ways builders introduce moisture problems and nail pops later.

Phase 7: Interior Finishes (5 to 8 Weeks)

Move-in ready new construction home interior with kitchen finishes in Omaha

This is the longest phase of active construction and the one with the most moving parts.

Cabinets, trim, flooring, tile, countertops, paint, and fixtures all involve multiple subcontractors working in sequence. Countertops cannot be templated until cabinets are set. Flooring goes in after paint. Light fixtures are the last thing installed before final inspection.

Interior finishes sequence:

  1. Interior doors hung and trimmed
  2. Cabinets installed (kitchen, bathrooms, laundry)
  3. Countertop template and fabrication (10 to 14 days lead time)
  4. Tile work (backsplash, shower, floors)
  5. Hardwood or LVP flooring installed
  6. Paint (walls, ceilings, trim)
  7. Plumbing trim-out (fixtures, toilets, faucets)
  8. Electrical trim-out (outlets, switches, fixtures, panel labeling)
  9. HVAC trim-out (registers, grilles, thermostat)
  10. Appliance delivery and installation
  11. Carpet installation (last flooring step before walkthrough)

Curious what your specific finish selections will cost? Regency’s Cost to Build a House in Nebraska guide breaks down per-square-foot ranges by finish level across the Omaha metro.

Phase 8: Exterior Work (Runs Concurrent With Interior Finishes)

Exterior work runs in parallel with interior finishes, not after.

Siding, brick or stone veneer, exterior paint, gutters, and concrete work (driveway, sidewalk, garage floor) all happen while interior subs are working inside. This parallel scheduling is one of the biggest timeline advantages of a builder with enough crew coordination to manage it. Delays in one trade do not automatically stall the other.

Landscaping is typically the final exterior item, completed in the last 1 to 2 weeks before walkthrough.

Phase 9: Final Inspections, Walkthrough, and Closing (2 to 4 Weeks)

The final inspection is a municipal building inspection, not a private home inspection.

The inspector reviews all completed work against permit drawings and code compliance. Most Regency homes pass final inspection on the first submission. If corrections are needed, they are minor and addressed within days.

After the municipal sign-off, Regency conducts a full homeowner orientation walkthrough. This is your punch list appointment.

What the orientation walkthrough covers:

  • Operation of all mechanical systems (HVAC, water heater, ERV/HRV)
  • Location of all shutoffs and electrical panel labeling
  • Warranty documentation and claim process
  • Cosmetic items noted for the punch list

Punch list items are addressed within 5 to 10 business days. Then you close.

Your lender will conduct a final appraisal of the completed home. Your rate, if locked during construction, is confirmed. After signing at the title company, keys are handed over.

Total elapsed time from Phase 1 through closing: 7 to 10 months for a Regency semi-custom home in the Omaha metro.

Before you commit to any builder, know the right questions to ask. Regency’s post on 5 Questions to Ask Your Omaha Home Builder breaks down what separates builders who protect your timeline from ones who let it bleed.

How Long Does Each Phase Take? Complete Timeline Table

PhaseWhat HappensDuration (Omaha / Regency)
Pre-Planning and FinancingLoan pre-approval, lot and plan selection4–8 weeks
Design Selections and PermitsFinish choices, permit filing and approval3–6 weeks
Site Prep and FoundationExcavation, footings, foundation walls, backfill2–4 weeks
FramingFloor system, walls, roof, dried-in4–6 weeks
Mechanicals (Rough-In)Plumbing, electrical, HVAC, all inspections3–5 weeks
Insulation and DrywallInsulation, hang, tape, finish coats2–3 weeks
Interior FinishesCabinets, flooring, paint, fixtures, appliances5–8 weeks
Exterior FinishesSiding, concrete, grading, landscapingConcurrent with interior
Final Inspections and WalkthroughMunicipal inspection, punch list, orientation1–2 weeks
ClosingFinal appraisal, title, signing, keys1–2 weeks
Total7–10 months

What Factors Make a Home Building Timeline Longer or Shorter?

Several variables consistently separate the 7-month builds from the 10-month builds, and almost none of them are about how fast a crew swings a hammer.

Permit Speed by Municipality

Douglas County permit timelines average 3 to 4 weeks for residential new construction. Sarpy County (Papillion, Bellevue, La Vista) runs 2 to 3 weeks. Bennington, Washington County, and Council Bluffs each operate their own processes.

Regency builds across all of these jurisdictions and files permits as a known local entity. That matters more than most buyers realize.

Design Selection Completeness

The single most controllable timeline factor is how quickly you complete your selections.

Buyers who come to their appointment knowing their must-haves lock everything in one session. Buyers who need multiple rounds of changes push cabinet and countertop lead times back, which delays trim-out by weeks.

Nebraska Weather

Nebraska winters are real. Concrete cannot be poured below 20°F without heating measures that add cost and time. Framing in January is possible but slower.

The flip side: Nebraska summers are reliable for construction. Builders who start foundations in April or May routinely hit 7-month timelines. Buyers who start in November should budget for an 8 to 10 month schedule.

Supply Chain and Material Lead Times

Windows, engineered lumber, and cabinets are the three materials that have historically created the most delay.

62% of builders reported window and door delivery delays of 4 or more weeks at least once in the prior 12 months. Regency pre-orders materials at permit filing, not at framing start, which compresses this risk significantly. Sourcing guidance from the National Association of Home Builders’ construction data resources confirms pre-ordering as the most effective mitigation strategy for single-family builders.

Spec Home vs. Build-to-Contract

A spec home (a home Regency starts before a buyer is under contract) is almost always faster to move into.

Spec homes are often mid-construction when buyers find them. Move-in can be as close as 60 to 90 days from purchase agreement. Regency’s available homes page lists current specs and estimated completion dates.

What Makes a Semi-Custom Home Timeline Faster Than a Fully Custom Build?

Home building timeline phases chart for Omaha Nebraska semi-custom homes

Semi-custom builds move faster than fully custom builds for three structural reasons.

  • Pre-engineered plans. Regency’s floor plans are permit-ready. There is no architectural design phase. The 6 to 12 weeks a full custom architect typically needs to produce permit drawings is already done.
  • Pre-approved material vendors. Regency has established supply relationships for windows, trusses, cabinets, and lumber. Lead times are known and scheduled before ground breaks.
  • Parallel trade scheduling. Regency runs enough homes in progress simultaneously that trades sequence efficiently across multiple sites. A one-off custom builder has less scheduling leverage with subcontractors.

The tradeoff is a more defined scope. You are choosing from Regency’s plan collection and selecting finishes within established options. What you get in return is a 7 to 10 month timeline instead of 14 to 22 months, and a more predictable budget.

The U.S. Census Bureau’s Characteristics of New Housing report puts it in numbers: fully custom homes averaged 14.3 months from permit to completion in 2024, versus 8.2 months for homes built for sale. That spread matches what Regency sees in the Omaha market every year.

Build TypeTypical TimelineDesign FlexibilityBudget Predictability
Production spec home60–120 days from contractMinimalHigh
Semi-custom (Regency)7–10 monthsModerateHigh
Fully custom14–22 monthsMaximumLower
Major renovation3–12 monthsHighVariable

The semi-custom model is what makes Regency’s 7 to 10 month timeline possible. See how the process works and what it means for your build. Explore Regency’s Semi-Custom Home Builder Process →

What Are the Most Common Causes of New Home Building Delays?

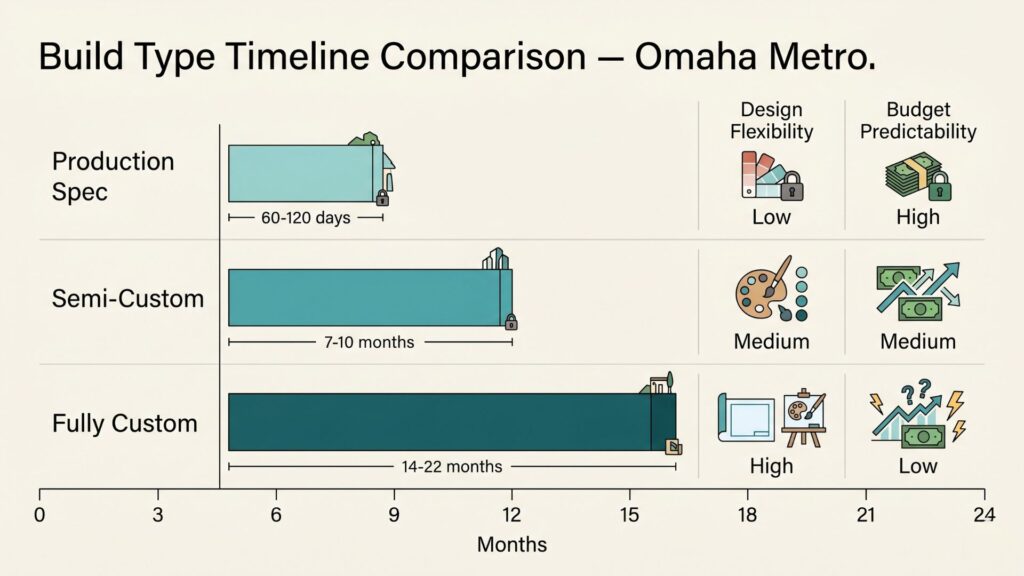

Comparison chart of semi-custom vs custom vs spec home timelines in Omaha

These five issues account for the majority of timeline overruns on new construction projects.

1. Incomplete Design Selections

Buyers who miss selections deadlines push cabinet and countertop orders back, which delays trim-out by weeks.

2. Permit Revision Requests

When permit drawings require corrections, resubmission adds 2 to 4 weeks depending on the municipality’s review queue.

3. Inspection Scheduling Conflicts

When rough-in inspections fall late, drywall cannot start. In busy permit seasons (spring and summer in Omaha), inspectors book out further than usual.

4. Weather Delays During Framing

Three consecutive weeks of rain or an early October freeze can push a framing completion date by 2 to 3 weeks.

5. Change Orders after Construction Begins

Every post-permit change order creates a ripple effect. Moving a wall requires a re-inspection. Changing a window size may require a permit revision. Changing cabinet styles after they are ordered involves restocking fees and new lead times.

The honest advice: make your decisions early and make them once.

How Does the Home Building Process Work in Omaha Specifically?

Open concept kitchen and living room in new construction home Omaha Nebraska

Omaha’s new construction market has some characteristics that differ from larger metros.

Lot availability is concentrated in master-planned communities rather than scattered infill lots. Regency builds in established communities with infrastructure already in place. Silver Meadows, Falling Waters, Council Bluffs, Papillion, and Bennington all have utilities, roads, and municipal services ready before ground breaks. That eliminates the utility extension delays that can add months to rural or custom lot builds.

The Omaha metro also has a stable, experienced subcontractor base. Unlike Phoenix or Austin, where construction surges in the early 2020s created severe labor shortages, Omaha’s growth has been steady rather than explosive. Trade scheduling is more reliable here than in high-growth Sun Belt markets.

Nebraska’s permitting process is locally administered. Each municipality runs its own review. Regency’s familiarity across Douglas, Sarpy, and Washington Counties, plus Pottawattamie County in Iowa, is a real practical advantage for timeline management.

The Rocket Mortgage new construction lending guide is a solid reference for buyers navigating construction-to-permanent financing for the first time, particularly around draw schedule structure and rate lock options.

See what is currently available and how close to move-in it is. Regency’s Available Homes page shows specs across all communities with estimated completion windows.

Frequently Asked Questions: Home Building Timeline

Does the school district calendar affect when I should start building?

Absolutely. If you want to be settled before the Omaha or Millard school year begins in August, you must have your contract signed and financing in place no later than the previous October. Waiting until the New Year to start the process almost guarantees a mid-semester move, which adds unnecessary stress to your family’s transition.

What happens to the timeline if my chosen materials go on backorder?

Supply chain hiccups still happen, particularly with specialized windows or high-end appliances. At Regency, we mitigate this by ordering long-lead items the moment your selections are finalized. If a delay is unavoidable, we pivot the interior work schedule to keep the momentum going elsewhere so your closing date stays as firm as possible.

Is it faster to build in a new subdivision or on a private rural lot?

Building in an established Regency community like Bennington or Papillion is significantly faster because the infrastructure, utilities, and grading are already complete. A private rural lot requires “raw land” development, which includes installing septic systems and running power lines, often adding three to five months of bureaucratic hurdles before a single shovel hits the dirt.

What Is the Difference Between a Building Permit and a Certificate of Occupancy?

A building permit authorizes construction to begin. A certificate of occupancy (CO) is issued after all final inspections pass and the home is deemed safe and complete for habitation. You cannot close and move in without a CO. In Douglas and Sarpy Counties, COs are typically issued within 3 to 5 business days of a passed final inspection.

What Should I Do During the Home Building Process?

Stay engaged without micromanaging. Visit the site weekly during framing and rough-in phases. Complete your selections appointments on schedule. Review your draw schedule with your lender. Ask your Regency project manager for a written milestone schedule at the start of construction so you have a baseline to track against.

How Do I Know if My Builder Is on Track?

Ask for a written construction schedule with milestone dates at contract signing. Request written updates at each phase completion. If milestones start slipping without explanation, that is a conversation to have early. Not at move-in.

Start Your Build Now: What to Do First

The Omaha new construction market in 2026 still favors buyers who move decisively.

Lot inventory in Regency’s active communities is not unlimited. Buyers who start pre-planning and financing in early spring are routinely closing and moving in by fall. Buyers who wait until midsummer to start are looking at winter completions or pushing their build to 2027.

Ready to talk through specifics? Call Regency Homes directly at 402-256-5727 or contact the team.

Regency Homes is the Best of Omaha 2026 winner. They build in Silver Meadows, Falling Waters, Papillion, Bennington, Council Bluffs, and Bellevue. When you are ready to build, the timeline starts with one conversation.

Share:

Blondo Point

Click to enlarge

Location: 214th St & Blondo St

School District: Elkhorn

Amenities:

  • 1 Minutes from the West Dodge Expressway

Sterling Chase

Click to enlarge

Location: 204th & Capehart Rd

School District: Gretna

Amenities:

  • Across from the new YMCA
  • Gretna Crossing nature park
  • Dog park

Harvest Creek

Click to enlarge

Location: 216th & Lincoln Rd

School District: Gretna

Amenities:

  • Green Space

Lions Gate

Click to enlarge

Location: 198th & Harrison St

School District: Gretna

Amenities:

  • Close to easy access traffic ways, established neighborhood, close day care centers, and several places of worship.
  • Oversized lots – many 82’ wide lots.
  • Minutes to West Dodge traffic way, the 180th & Center shopping mile, the I-80 interstate system, and to grocery and other shopping services.

Liberty

Click to enlarge

Location: 43rd & Capehart Rd

School District: Bellevue

Amenities:

  • Treed and nature reserve lots available
  • 11 minutes from Shadow Lake Towne Center
  • 15 minutes from Offutt Air Force Base

Sumtur Crossing

Click to enlarge

Location: 114th & Schramm Rd

School District: Papillion La Vista

Amenities:

  • Close to Sumtur Amphitheater (concerts, movies and plays)
  • Adjacent to the 450 acre Walnut Creek Recreation area with its 105 acre lake (hiking, biking and fishing)

Granite Creek

Click to enlarge

Location: 108th & Lincoln Rd

School District: Papillion La Vista

Amenities:

  • Adjacent to the proposed NRD lake area
  • Close to Sumtur Amphitheater (concerts, movies and plays)
  • Close to the 450 acre Walnut Creek Recreation area with its 105 acre lake (hiking, biking and fishing)
  • Close to Werner Ball Park – Home of the Omaha Storm Chasers

Founders Ridge

Click to enlarge

Location: 126th & Hwy 370

School District: Papillion La Vista

Amenities:

  • Adjacent to Prairie Queen Lake and Recreation Area-hiking, biking and fishing
  • Adjacent to Werner Ball Park – Home of the Omaha Storm Chasers
  • Minutes to the I-80 Interstate system
  • Enjoy the Sumtur Amphitheater for concerts, movies and plays, the Shadow Lake Towne Center shopping, and the Walnut Creek Recreation and lake area for hiking, biking and fishing

Remington West

Click to enlarge

Location: West of Remington Ridge (South of Harrison on 192nd St)

School District: Gretna

Amenities:

  • Trails and Nature reserve

Remington Ridge

Click to enlarge

Location: South of 192nd & Harrison St

School District: Gretna

Amenities:

  • Trails and Nature reserve

Bridgeport

Click to enlarge

Location: 180th St & Cornhusker Road

School District: Gretna

Amenities:

  • Coved, park-like streetscape
  • Extensive green space and trail network
  • Community Swimming Pool

Aspen Creek North

Click to enlarge

Location: 1 mile N of 192nd & Hwy 370

School District: Gretna

Amenities:

  • Adjacent to the all-new Gretna school campus facility

Daybreak Springs

Click to enlarge

Location: 192nd St & Fort St

School District: Elkhorn

Amenities:

  • Access to green space
  • Nearby Golfing
  • Adjacent to the Fort Street Improvement Project

Calarosa

Click to enlarge

Location: 204th St and Fort St

School District: Elkhorn

Amenities:

  • 3 miles from Maple St Shopping Corridor

Indian Pointe

Click to enlarge

Location: 198th & Harrison St

School District: Gretna

Amenities:

  • Close to easy access traffic ways, established neighborhood, close day care centers, and several places of worship.
  • Oversized lots – many 82’ wide lots.
  • Minutes to West Dodge traffic way, the 180th & Center shopping mile, the I-80 interstate system, and to grocery and other shopping services.

Newport Vista

Click to enlarge

Location: North 168th Street and Bennington Road

School District: Bennington

Amenities:

  • View lots
  • Bennington school across the street
  • Adjacent to a nature reserve
  • View of Bennington Lake

Kempten Creek

Click to enlarge

Location: 165th Street and Bennington Road

School District: Bennington

Amenities:

  • View lots
  • Adjacent to regional park

Anchor View

Click to enlarge

Location: 3 blocks N of 168th Ida

School District: Elkhorn

Amenities:

  • Overlooks Flanagan Lake, a 220-acre lake with 730 acres of recreation
  • Public access Flanagan Lake as well as facilities for boat access
  • Blocks of walking & biking trails
  • Playgrounds and youth sport fields

Anchor Pointe

Click to enlarge

Location: 198th & Harrison St

School District: Gretna

Amenities:

  • Close to easy access traffic ways, established neighborhood, close day care centers, and several places of worship.
  • Oversized lots – many 82’ wide lots.
  • Minutes to West Dodge traffic way, the 180th & Center shopping mile, the I-80 interstate system, and to grocery and other shopping services.

Falling Waters

Click to enlarge

Location: 198th & Harrison St

School District: Gretna

Amenities:

  • Close to easy access traffic ways, established neighborhood, close day care centers, and several places of worship.
  • Oversized lots – many 82’ wide lots.
  • Minutes to West Dodge traffic way, the 180th & Center shopping mile, the I-80 interstate system, and to grocery and other shopping services.
Avatar
Crystal contacted us to discuss a project
Avatar
Melissa contacted us to discuss a project
Avatar
FERGUSON contacted us to discuss a project
Avatar
Melissa has downloaded our Planning Guide
Avatar
Hope has downloaded our Planning Guide
Avatar
Julie has downloaded our Planning Guide
